Policypublished

AI Data Center Builders Offer Concessions as Local Backlash Hardens

Oracle, Microsoft and OpenAI are pairing outreach with promises on power, water and local benefits. The unresolved test is whether concessions can overcome opposition that is already delaying projects and reshaping state policy.

By 4 min read
AI Data Center Builders Offer Concessions as Local Backlash Hardens

Listen to this story

The audio brief

About 1:33
0:001:33
Read transcript
At least 75 U.S. data-center projects, worth about 130 billion dollars combined, were blocked or delayed by local opposition in the first three months of 2026. That pressure is forcing the companies behind the AI buildout to offer more than jobs and tax revenue. They are promising to pay for power infrastructure, limit water use, drop tax-break requests, and fund local benefits. The stakes are especially clear in Doña Ana County, New Mexico, where Oracle’s 2.45-gigawatt Project Jupiter is tied to the company’s 300-billion-dollar computing deal with OpenAI. Oracle has sponsored a food pantry and a Boys and Girls Club, promoted local amenities, and switched the project’s planned power source from natural-gas generators to Bloom Energy fuel cells. Oracle says that change reflects community responsibility, though people familiar with the project told Bloomberg that difficulty obtaining gas turbines also played a role. The facility had generated almost 80 million dollars in state and local taxes by late July. Meanwhile, Pennsylvania now requires developers to fund connected grid infrastructure and win local approval; New York has imposed a one-year moratorium; and Texas requires power upgrades, water reuse, and lower electricity costs, with a separate audit reportedly freezing new projects. Microsoft’s concessions did not end opposition in Michigan. That is the unresolved test: whether promises can overcome organized resistance before construction begins.

Story brief

3 key points

At least 75 US data-center projects worth roughly $130 billion were blocked or delayed by local opposition in Q1 2026, pushing developers toward binding infrastructure, water, tax, and community concessions. Pennsylvania now requires developers to fund associated grid infrastructure and secure local approval; New York imposed a one-year moratorium, while Texas tightened obligations and reportedly froze new projects...

  1. 01

    Project Jupiter is tied to Oracle’s $300 billion computing deal with OpenAI and had generated nearly $80 million in state and local taxes by late July.

  2. 02

    Microsoft dropped nondisclosure agreements and property-tax breaks in Michigan, but organized opposition still slowed the project.

  3. 03

    Texas requires developers to fund electrical upgrades, reuse their water, and reduce electricity costs; a separate audit reportedly froze new projects.

AI data-center developers are being pushed to offer more than jobs and tax revenue. As local resistance delays projects, companies are promising to fund power infrastructure, limit water use, drop tax-break requests and invest in nearby communities—while states move toward tougher rules and, in some cases, pauses on new construction.

The scale of the resistance is no longer limited to a few contentious hearings. Data Center Watch counted at least 75 projects, worth about $130 billion combined, that were blocked or delayed by local opposition in the first three months of 2026. Concerns span electricity costs, water consumption, environmental effects and the local economic bargain offered by enormous computing facilities.

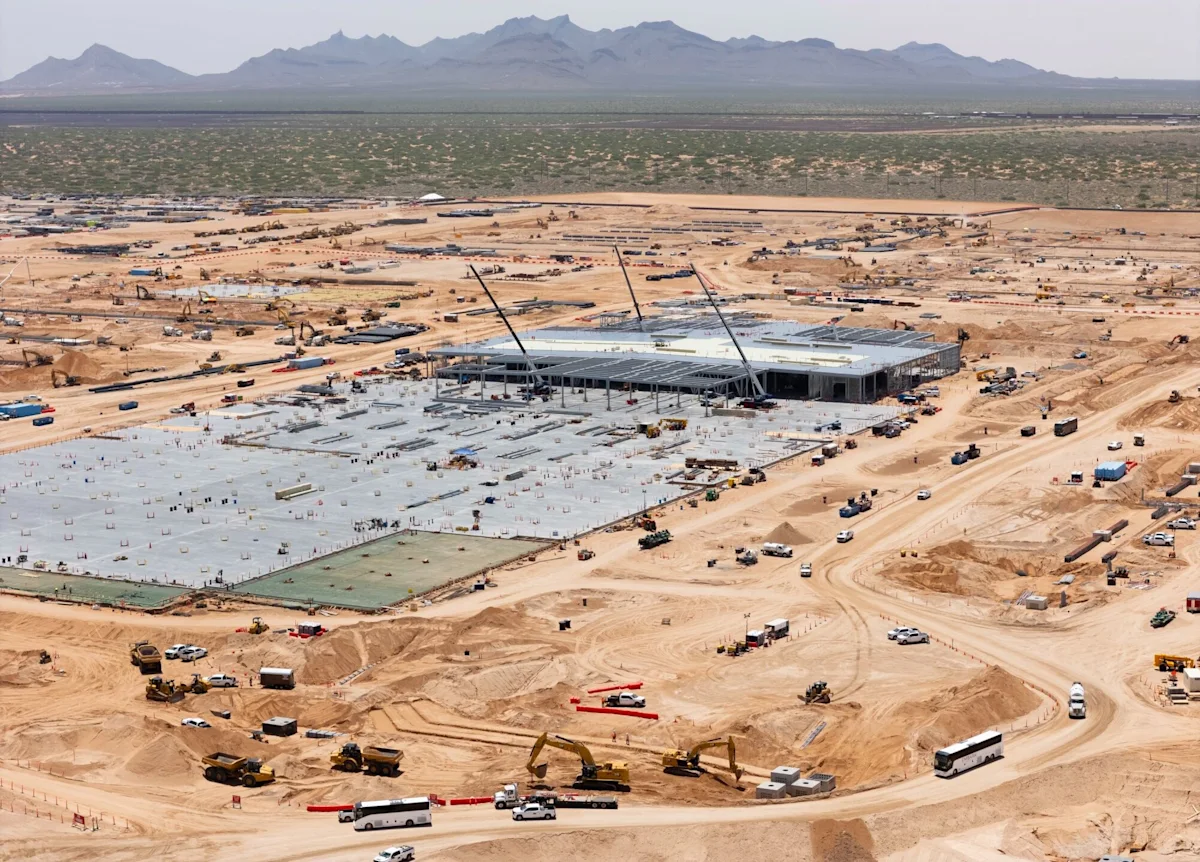

In Doña Ana County, New Mexico, Oracle and its partners have sent mailers, sponsored groups including a food pantry and Boys & Girls Club, and backed local amenities around Project Jupiter. The 2.45-gigawatt facility is tied to Oracle’s $300 billion computing deal with OpenAI, making any permitting delay unusually consequential for the companies behind it.

The campaign follows anger over the project’s initially limited public disclosure. Oracle has also changed its planned power source from natural-gas generators to Bloom Energy fuel cells. The company says the shift reflects responsible community participation; people familiar with the project told Bloomberg that difficulty obtaining gas turbines also contributed. Oracle says Project Jupiter had generated almost $80 million in state and local tax revenue by late July.

The scale of the slowdown
At least 75Projects blocked or delayed

Local opposition blocked or delayed at least 75 data-center projects in the first quarter of 2026, according to Data Center Watch.

About $130 billionCombined project value

Data Center Watch estimated those blocked or delayed projects were worth about $130 billion combined.

Pennsylvania Gov. Josh Shapiro’s new executive order requires developers to pay for electricity generation, transmission, distribution and other infrastructure connected to their projects. It also calls for transparent stakeholder engagement, local hiring and training, community-benefit agreements, and strict water and environmental standards. Bloomberg also reports the order requires local approval before developers can receive state permits.

Three versions of the emerging state response

  • New York: Gov. Kathy Hochul ordered a one-year moratorium on large data centers while the state develops protections for the environment, ratepayers, the grid and communities.
  • Texas: Gov. Greg Abbott’s June directive requires companies to pay for electrical upgrades, reuse their own water and reduce electricity costs. Bloomberg separately reported that Abbott froze new projects pending a comprehensive audit.
  • Pennsylvania: Shapiro’s order ties project approval to developer-funded infrastructure and local obligations.

Microsoft has said it will stop seeking tax breaks from communities where it builds data centers and adopted a community-first infrastructure policy. In Lowell Township, Michigan, it later dropped nondisclosure agreements and property-tax breaks after opposition organized before the company was publicly identified; the project is still moving slowly.

OpenAI is meeting residents near its planned more-than-$30 billion facility outside Savannah, Georgia, and has pledged to conserve water and pay for power and energy infrastructure. Meta has spent millions on television advertisements presenting its data centers as positive local investments. These moves show a sector trying to make its buildout visible on terms other than model capability or national competitiveness.

The backlash cuts across party lines. The National Republican Senatorial Committee warned that data centers could become a major 2026 midterm issue, while candidates and governors in states including Pennsylvania and Texas have made their costs and safeguards central political questions. A satirical Liquid Death and Garage Beer advertisement targeting data-center water use is another sign that the dispute has moved beyond planning commissions.

The open question is whether company pledges will change the underlying approval fight. In Lowell Township, Microsoft’s revisions did not end organized opposition. In New Mexico, Oracle’s fuel-cell change leaves a major remaining hurdle: state permits for the grid needed to power Project Jupiter. The new model for AI infrastructure may be less about winning incentives before a project is announced and more about accepting enforceable local costs before construction can proceed.
